We guide sustainable campus growth and development and oversee campus-wide planning, including space allocation, project planning for capital projects and facilities upgrades. We create spaces that support learning, research, and engagement while integrating with our surrounding community.
Campus Master Plan

Campus Master Plan

Discover our vision for growth with plans for new spaces, transit-friendly access, and a sustainable campus future.
Space management principles

Space management principles

Guidelines and standards that ensure effective use of space across the university.
Asset Management Plan

Asset Management Plan

The Asset Management Plan provides a five-year rolling approach that guides infrastructure decisions in step with institutional priorities.

Capital Planning Cycle

Combining fiscal planning to create a comprehensive multi-year plan

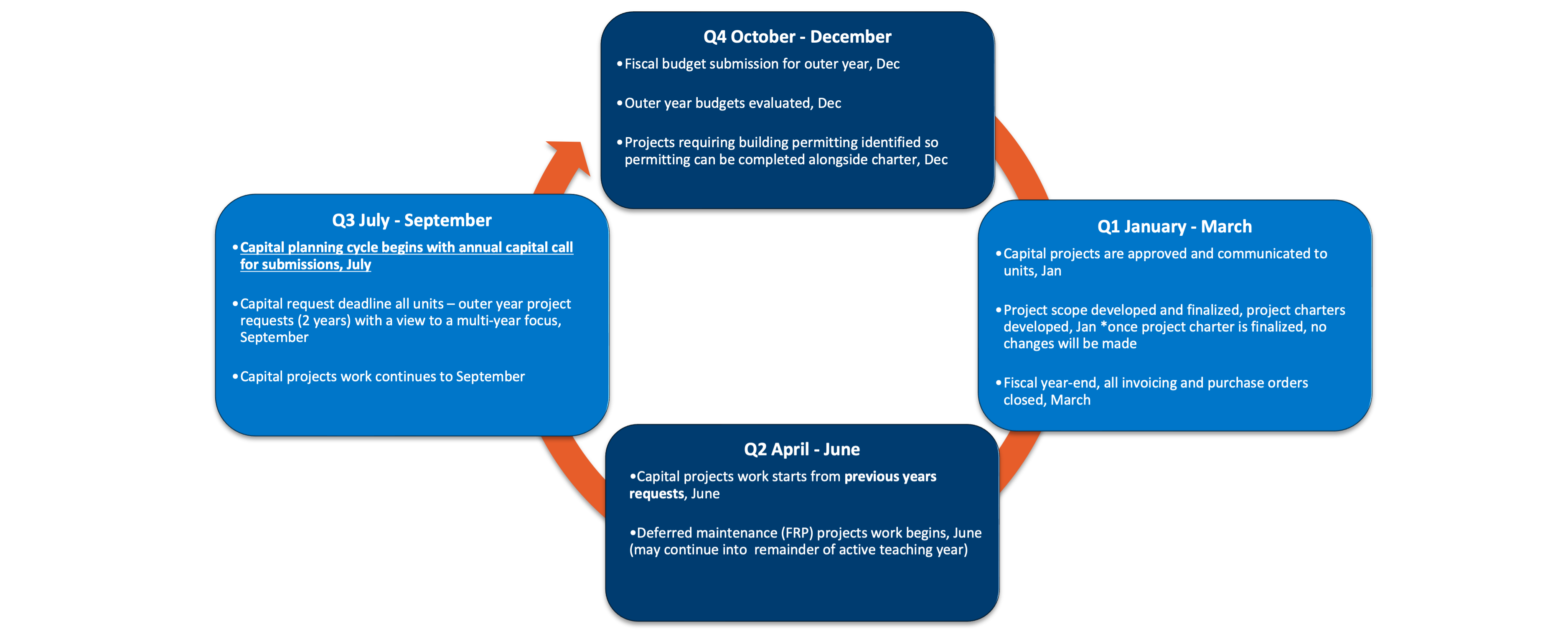

Circular diagram illustrating the Capital Planning Cycle from Q1 to Q4
Q1 (January – March):
  • Capital projects are approved and communicated to units, Jan
  • Project scope developed and finalized, project charters developed, Jan *once project charter is finalized, no changes will be made
  • Fiscal year-end, all invoicing and purchase orders closed, March
Q2 (April – June):
  • Capital projects work starts from previous years requests, June
  • Deferred maintenance (FRP) projects work begins, June (may continue into remainder of active teaching year)
Q3 (July – September):
  • Capital planning cycle begins with annual capital call for submissions, July
  • Capital request deadline all units – outer year project requests (2 years) with a view to a multi-year focus, September
  • Capital projects work continues to September
Q4 (October – December):
  • Fiscal budget submission for outer year, Dec
  • Outer year budgets evaluated, Dec
  • Projects requiring building permitting identified so permitting can be completed alongside charter, Dec
